Solar That Keeps Working When the DG Starts: 40 kW on a Tin Shed at Prabhat Namkeen, Greater Noida

| Client | RD Food Products (Prabhat Namkeen) |
|---|---|
| Location | Surajpur, Greater Noida, UP |
| System | 40 kW |
| Grid tie inverters (GTI) | Growatt, 25 kW + 15 kW |
| Commissioned | 2024 |
| MGetEnergy scope | EPC, tin shed mounting, grid and DG synchronisation, commissioning, five year AMC |
| Maintenance contract | CAMC, 2025 – 2030 |
RD Food Products makes namkeen under the Prabhat Namkeen brand. Its Site C production unit in Surajpur, Greater Noida, has a tin shed roof and a diesel generator for power cuts.
In 2024 we installed and commissioned a 40 kW rooftop solar plant on that roof. The plant uses 595 Wp half-cut mono PERC modules feeding two Growatt grid tie inverters of 25 kW and 15 kW. It is synchronised with both the grid and the DG, so it keeps producing through power cuts instead of switching off. We maintain it under a five year AMC.
Why a factory with a DG needs more than ordinary solar
A standard on-grid inverter switches off the moment grid power fails. This is a safety feature called anti-islanding. At a factory with a DG, that means the solar sits idle for exactly the hours when the site is running on diesel, which is the most expensive power it buys.
Letting solar simply run alongside the DG is not safe either. If the factory's load drops, solar can push power back into the generator, which a DG cannot absorb. A DG synchronisation controller solves both problems. It lets the inverters run while the DG is on and holds back solar output so the DG always carries a safe share of the load.
Mounting on a tin shed roof

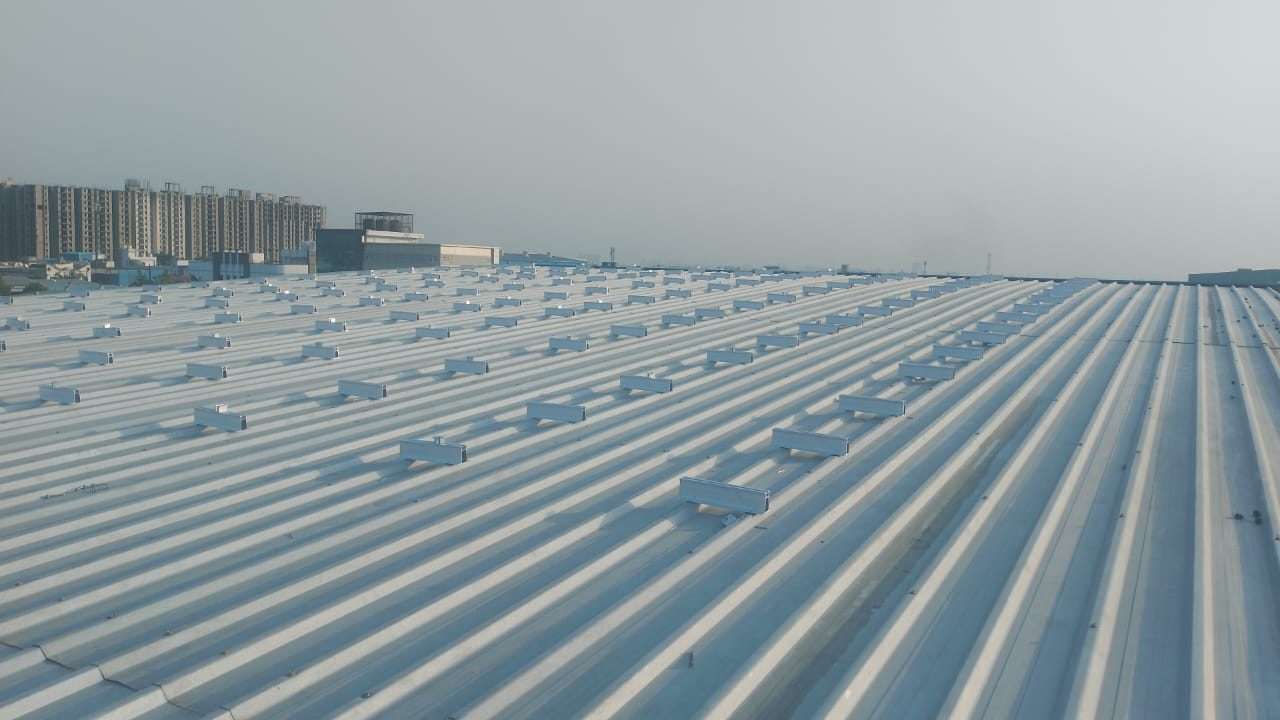

The roof is a profiled metal sheet. We screwed the mounting rails through the sheet, with a sealing washer at every fixing to close the hole against rain. The rails run across the ribs of the sheet so the load is spread over several ribs.
On the roof and down the electrical room wall, perforated cable trays keep the cables tidy and off the hot sheet.

What we installed

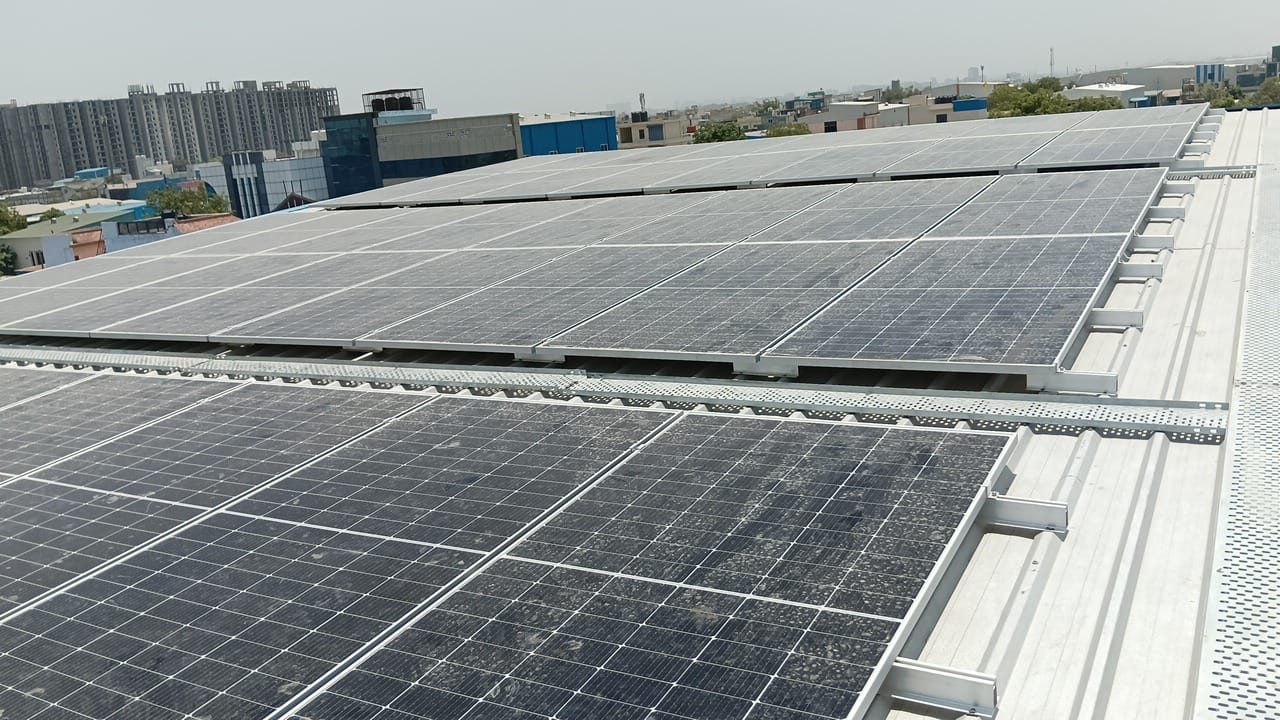

- Solar array: 40 kW of 595 Wp half-cut mono PERC modules on the production unit's tin shed roof

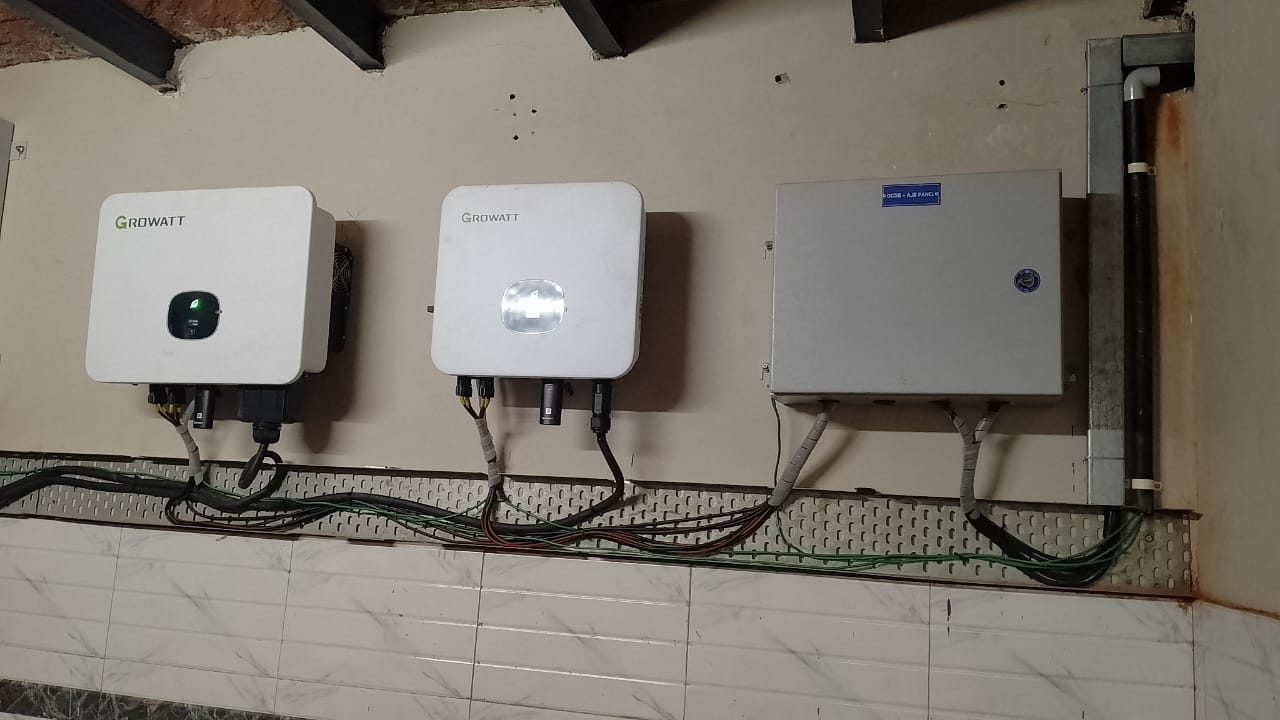

- Inverters: Growatt grid tie, 25 kW and 15 kW, wall mounted in an indoor electrical room
- DC distribution and array junction box panel beside the inverters
- DG synchronisation controller, so the plant runs with either the grid or the DG
- Mounting: rails screwed through the roof sheet, sealed with washers at every fixing
The two inverters add up to 40 kW, matching the array. Splitting the plant across two units also means that if one inverter needs attention, the other keeps generating.
How the plant behaves when power fails
- Grid present: solar supplies the factory load first and the grid makes up the rest
- Grid fails, DG runs: the controller lets the inverters work alongside the DG and limits solar so the generator is never back-fed
- Grid returns: the plant goes back to normal operation
Every unit of solar produced while the DG is running is diesel that does not have to be burned. Fuel savings depend on how many hours of outage the site sees, so we do not quote a fixed figure.

Maintained under a five year AMC
- Module cleaning and inspection
- Roof fixings and sealing washers checked for leaks
- Inverter fault logs, ventilation and cooling
- DG synchronisation controller checks
- Earthing and protection checks
What this means for other food units
Many food processing units around Surajpur and Kasna have metal sheet roofs and a DG set. Neither rules out solar. The roof needs a sealed fixing method, and the DG needs a synchronisation controller. With both in place, the plant earns its keep during power cuts as well as on normal days.
Frequently asked questions
Can rooftop solar run with a diesel generator?
Yes, with a DG synchronisation controller. Without one, an on-grid inverter switches off whenever the grid fails. At Prabhat Namkeen, the controller keeps the 40 kW plant running alongside the DG.
Can solar be installed on a tin shed roof?
Yes. Here the rails are screwed through the metal sheet, with a sealing washer at every fixing to keep the roof watertight.
What size is the system?
40 kW, using 595 Wp half-cut mono PERC modules and Growatt inverters of 25 kW and 15 kW. It was commissioned in 2024.
Does the plant work if both the grid and the DG are off?
No. It is an on-grid plant without batteries, so it needs either the grid or the DG running.
Who maintains it?
MGetEnergy, under a five year AMC running from 2025 to 2030.
Planning rooftop solar on a tin shed, or for a factory with a DG set?
MGetEnergy designs, installs and maintains rooftop solar for food units, factories and warehouses with metal sheet roofs and diesel generators, across Delhi NCR and beyond.
+91 98218 76325 wecare@mgetenergy.com
Request a site assessment
